Quotes to install an oven and induction cooktop

We asked for quotes to install our oven. The cheapest and the dearest were more than $1,000 apart.

The numbers caught me out. In my head (and my ignorance), connecting an oven was an afternoon's work and a few hundred dollars. The first quote came back at $3,014 — most of the price of the oven itself. So, before agreeing to anything, I went looking to better understand why it's such a big job.

Our new 90 cm Westinghouse needs a circuit of its own: 9.6 kW, 40 amps, hardwired, single phase. The old Smeg ran its oven on a 20 amp circuit and its cooktop on gas, so there was nothing here that could carry it.

That means new cable the whole way: out of the switchboard on the garage wall, up into the roof cavity, along the length of the house, and down into the kitchen. About 25 metres. Plus fittings, breaker and isolation switch, and the labour to do it all.

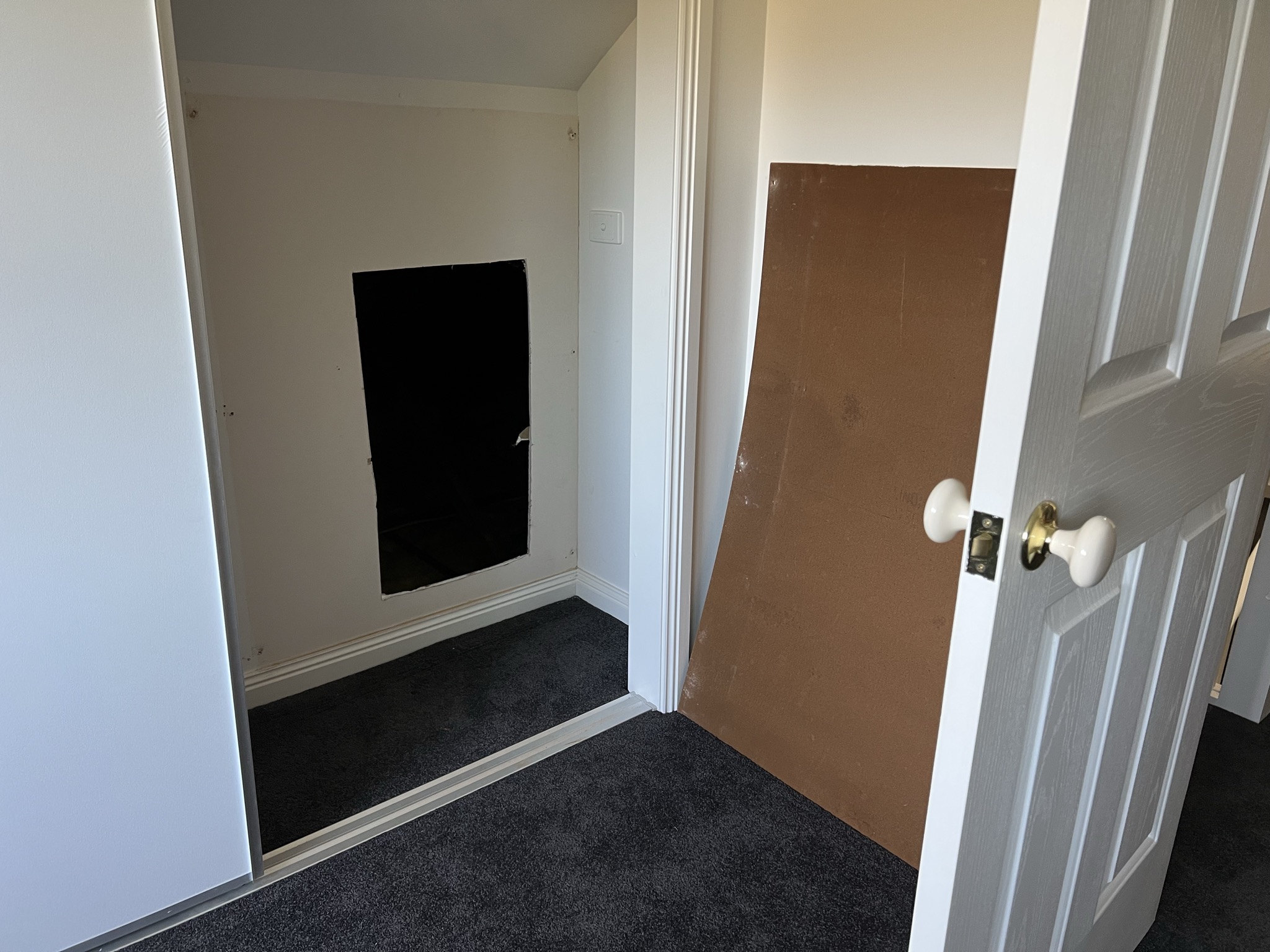

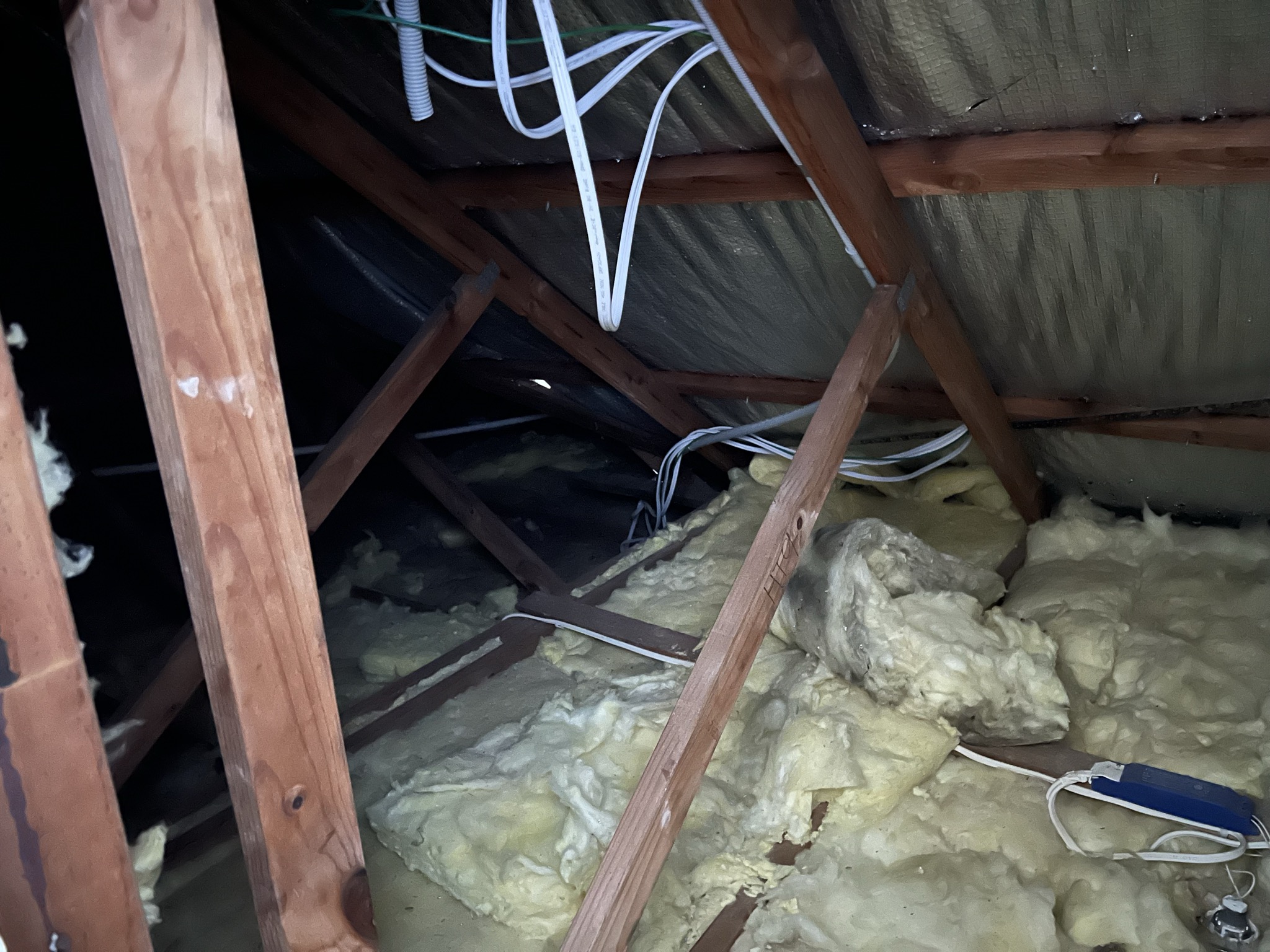

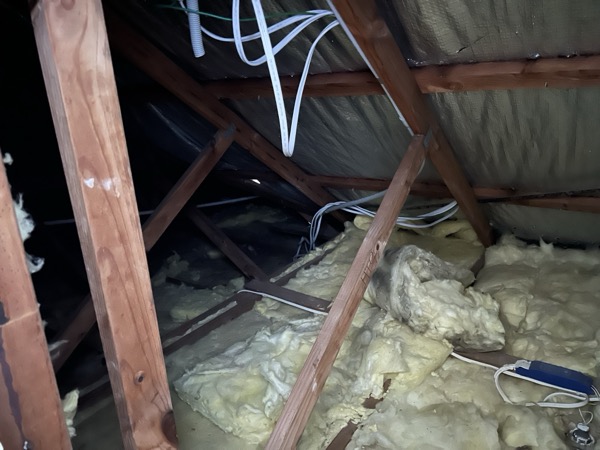

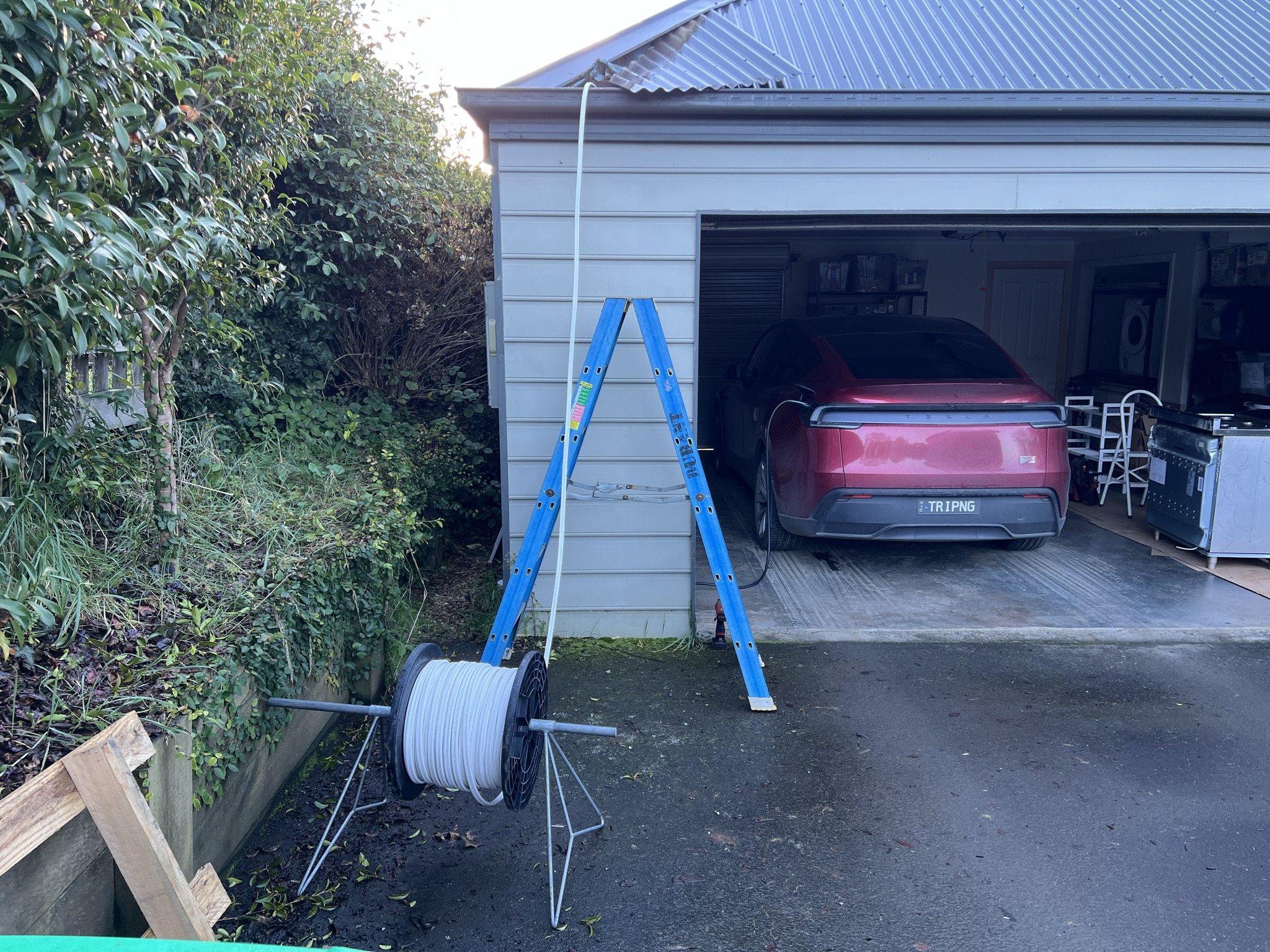

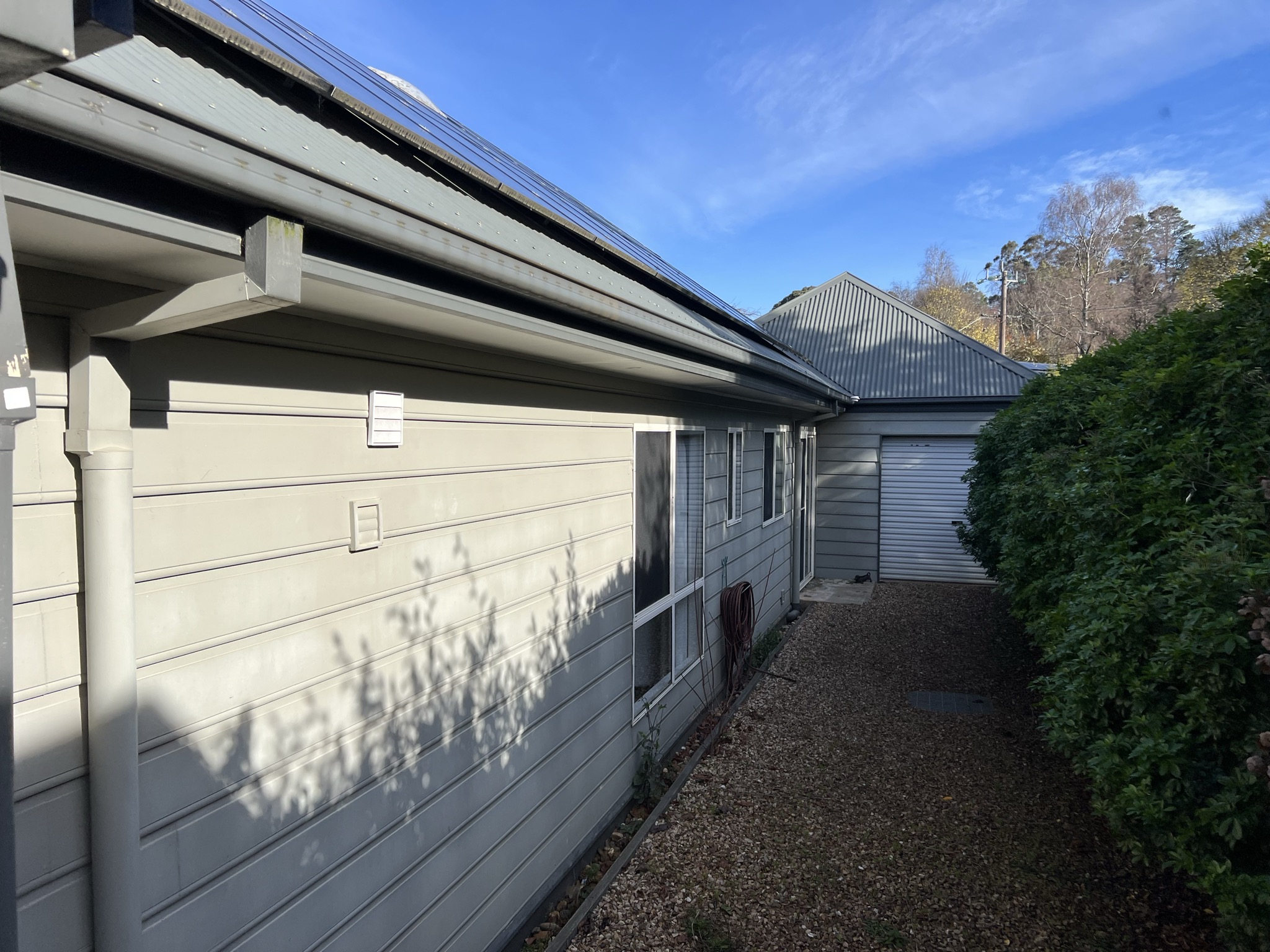

To try to simplify the quoting process, I sent photos (eg the 25 metres from switchboard to kitchen, the roof cavity access) and all the info I could. I asked them to itemise the quote (at least separating parts and labour) so I could understand where the costs are, and to eliminate anything that wasn't needed (such as disposal or tile cutting), or add what wasn't quoted (such as gas disconnection).

Only one company itemised their quote prices. Here's their breakdown, which the other totals broadly agree with:

  • 25 m cable run — $440
  • Other materials — $275
  • 40 A breaker with RCD protection — $275
  • Labour — $1,210
  • Removing the old cooker and capping the gas — $330

So, about half the bill is labour, and the largest single material is the cable. Not because copper is precious, but because 40 amps over 25 metres through roof insulation needs 10 mm² cable — twice the cross-section of ordinary house wiring, and stiff enough to be a genuine wrestle through a roof cavity.

Rather than cold-calling strangers, we asked the businesses who had already worked on this house. Lexity, who once rescued us from a slug fried across our safety switch. Sapphire Solar, who added our Powerwall 3s. Lightning Energy, who installed our solar, the original Powerwall 2 and the EV charger. O'Brien Electrical, who did our air conditioning and the heat pump. The Good Guys, where we had bought the oven, had already tried to organise a couple of installers but their system fell over and their quote was highest.

One wrote back to say they only do solar and batteries. One responded quickly, then didn't send a quote for a month. Only one could quote from those photos without driving out to look.

Comparing the three usable quotes covered slightly different work. Capping the gas line needs a licensed gasfitter, and not everyone included it. Once I had added back whatever each quote left out, the complete job ran from $2,255 to more than $3,300.

The best price was O'Brien, who had quoted us seven months earlier while they were here installing the air conditioning. I went back and told them what had changed: no tile cutting needed, because an unused power point beside the stove could become the isolation switch, and we had sold the old cooker, so there was nothing to cart away. They came back $311 lower, including an extra "VIP" discount.

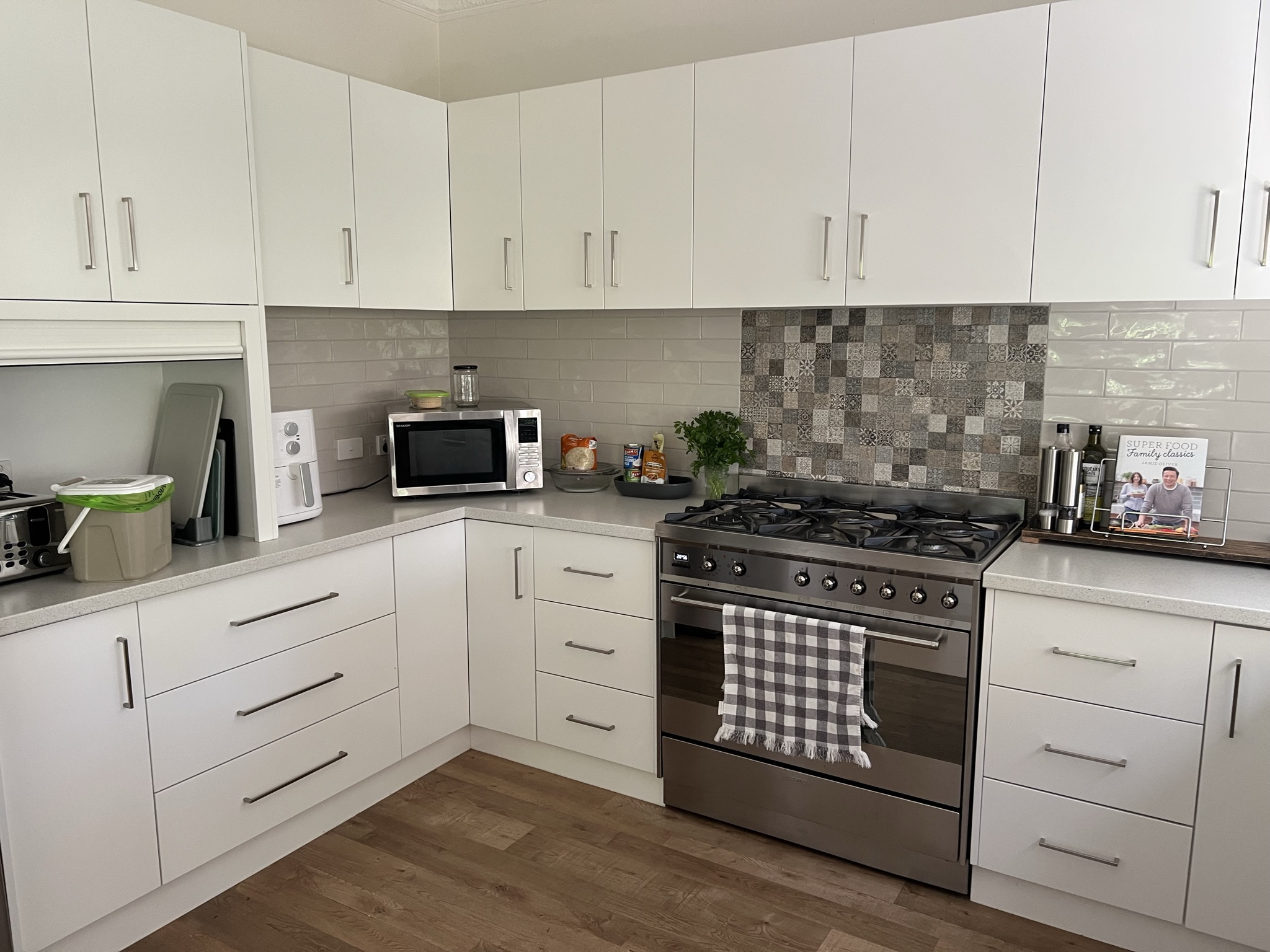

Coming up: The actual oven installation.
